SysadminNews

Anthropic, Macquarie and GIC Form Theseus Infrastructure

On this page
  1. What the structure is doing
  2. The electricity sentence
  3. What is not in the announcement
  4. Why this matters if you never touch a hyperscale build
  5. Sources and further reading

Anthropic, Macquarie Asset Management and Singapore's GIC announced Theseus Infrastructure on August 10, 2026. It is a platform that will develop, operate and lease data centre capacity to Anthropic under long term agreements, with an initial focus on the United States. Macquarie funds and GIC own the platform and put up the majority of the equity for each project, and Anthropic signs on as anchor tenant. There is a second commitment in the release that deserves as much attention as the first: Anthropic says it will cover electricity price increases that consumers would otherwise face from these sites.

The short answer

Theseus Infrastructure is a new platform announced on August 10, 2026 that will develop, operate and lease data centre infrastructure to Anthropic under long term agreements. Funds managed by Macquarie Asset Management, together with GIC, will own the platform and fund the majority of the equity for each project. Anthropic will be the anchor tenant, and has committed to cover electricity price increases consumers would otherwise face from these sites.

USinitial focus for the sites Theseus will develop
majorityof each project equity funded by Macquarie and GIC
anchortenant role Anthropic takes on every site

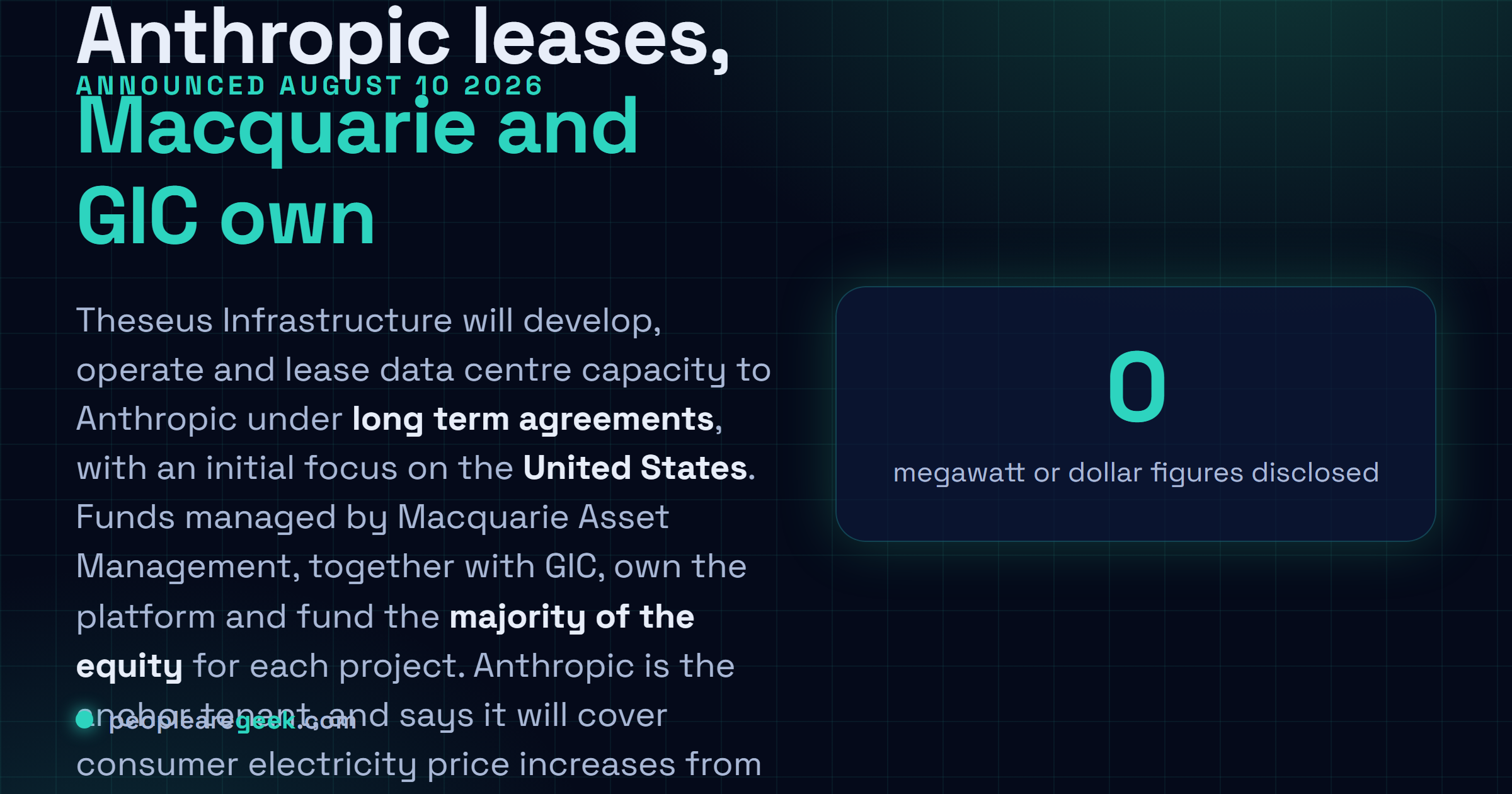

Answer card describing Theseus Infrastructure, a platform announced on August 10 2026 by Anthropic, Macquarie Asset Management and GIC to develop, operate and lease data centre infrastructure to Anthropic as anchor tenant under long term agreements, with Macquarie funds and GIC owning the platform and funding the majority of equity per project, an initial focus on the United States, and a commitment from Anthropic to cover consumer electricity price increases.
The announcement in one card. Source: the joint press release from Macquarie Group, August 10, 2026. PNG

The interesting thing about this announcement is not that another AI company needs more data centres. It is who is holding the asset when the music stops, and what got promised to the people who live near the substation.

Anthropic, Macquarie Asset Management and GIC announced Theseus Infrastructure on August 10, 2026. It is a platform to develop, operate and lease data centre infrastructure at scale, purpose built for Anthropic's capacity needs, on long term agreements. The three parties will identify and develop new sites together. Anthropic is the anchor tenant on each one. The initial focus is the United States.

Funds managed by Macquarie Asset Management will own the platform alongside GIC, and the two will fund the majority of the equity for each project. Macquarie brings a long history of developing and operating large scale digital infrastructure. GIC brings sovereign scale infrastructure investment experience and, notably, an existing investment in Anthropic itself.

What the structure is doing

Strip away the branding and this is a sale and leaseback pattern applied before the asset exists.

An AI company needs a very large, very specific building with an extraordinary amount of power delivered to it. Building that itself means committing capital to a twenty or thirty year asset. The equipment that goes inside it turns over every two or three years. Those two timescales do not want to live on the same balance sheet, and putting them there means the slowest depreciating part of the business absorbs capital that the fastest moving part is competing for.

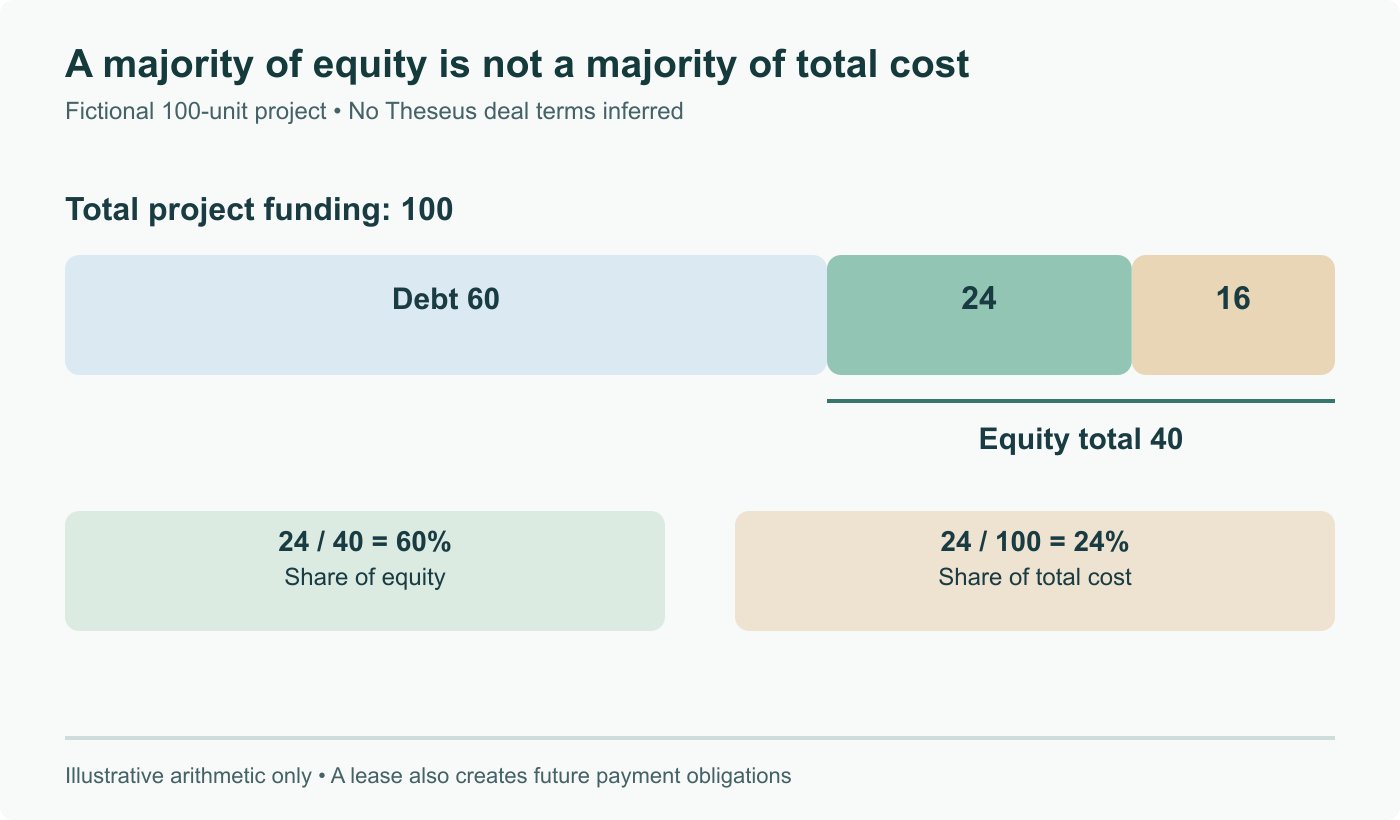

The anchor tenant model separates them. Infrastructure investors, whose return horizons are measured in decades and who are used to underwriting long lived physical assets, own and finance the building. The tenant signs a lease long enough to make the debt serviceable. That signature is what makes the project financeable in the first place: without it there is no predictable cash flow and no lender.

What the tenant gives up is the upside of ownership and a good deal of flexibility, because the lease is an obligation that outlives any particular hardware generation. What the tenant gets is capacity it does not have to fund, on a timeline set by people whose entire business is delivering large physical projects.

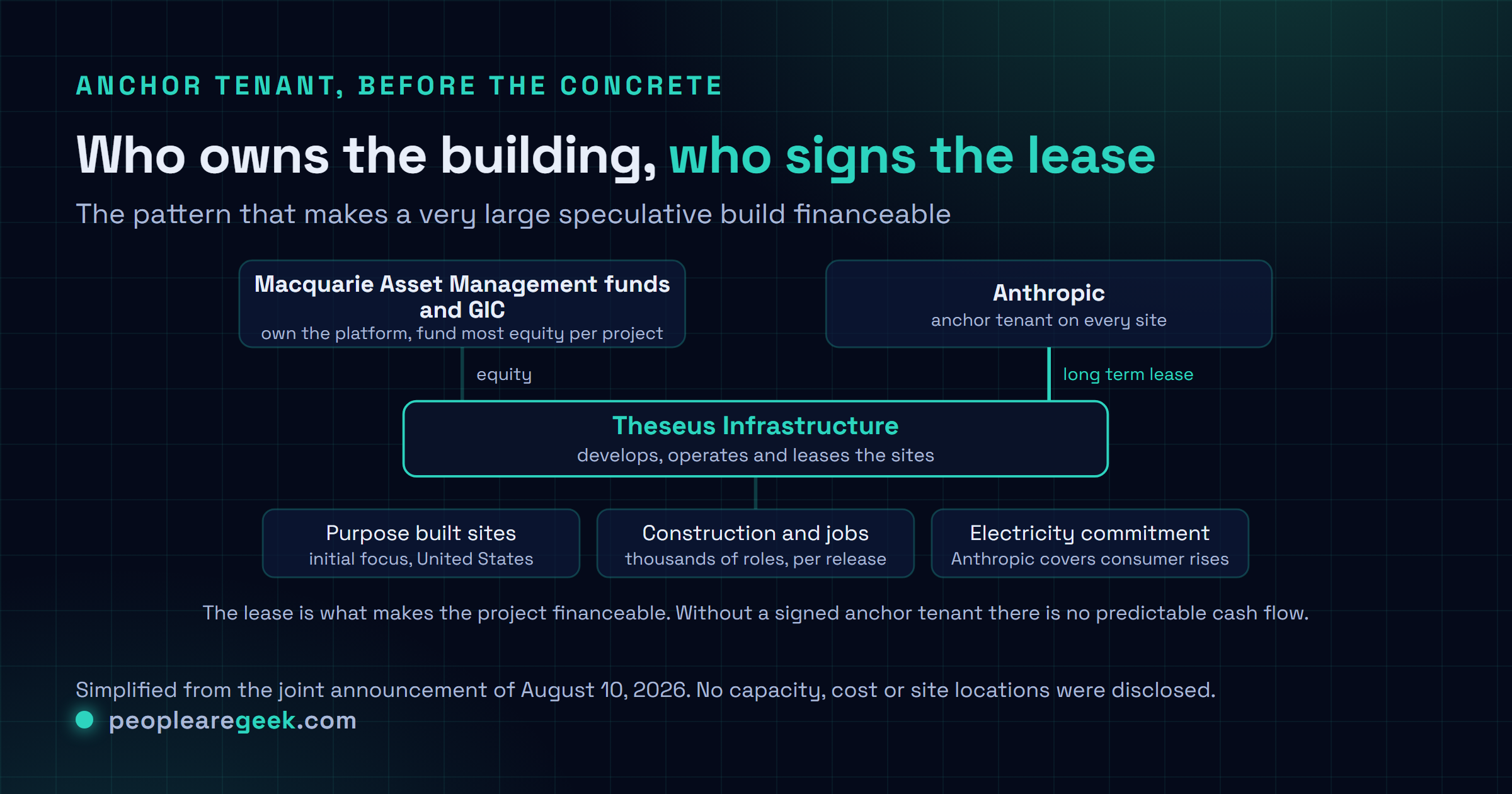

Diagram card showing the Theseus Infrastructure structure: Macquarie Asset Management funds and GIC jointly own the platform and fund the majority of equity per project, the platform develops and operates each site, and Anthropic signs long term leases as anchor tenant while committing to cover consumer electricity price increases.
Who owns what, and who signs what. Based on the joint announcement of August 10, 2026. PNG

The electricity sentence

Buried in a paragraph about job creation is the line that will matter most locally. Anthropic will cover electricity price increases that consumers otherwise may face from these sites, in line with commitments the company announced earlier in 2026.

That sentence exists because of a specific and increasingly effective objection. When a very large new load connects to a regional grid, the transmission and generation upgrades needed to serve it get paid for through mechanisms that can spread cost across the existing ratepayer base. The data centre gets its power. Everyone else's bill goes up. Whether that happens, and by how much, depends entirely on how a given interconnection and tariff arrangement is written, which is why it varies so much between jurisdictions and why it has become such a durable point of local conflict.

The commitment does not have a published mechanism attached to it. It will be implemented, or not, in interconnection agreements and rate filings that are considerably less readable than a press release. But its presence in the announcement is a signal about what is currently blocking these projects. Capital is not the constraint. Permission is.

We have watched that constraint bind elsewhere: New York moved on a data centre moratorium, and load growth in Data Center Alley has been reshaping how utilities plan. A developer that arrives at a county board with a written answer to the electricity bill question is in a materially different negotiation than one that does not.

What is not in the announcement

No megawatt figure. No dollar figure. No named sites. The release says the developments will require significant capital investment and will create thousands of construction jobs and permanent operational roles in host communities, and that is the extent of the quantification.

That is worth stating plainly, because this is the kind of story that acquires numbers as it travels. The verifiable content is the structure, the parties and the commitments. Everything else is inference.

Why this matters if you never touch a hyperscale build

Because these platforms are competing for inputs you also need.

Grid interconnection queue positions, high voltage transformers, medium voltage switchgear, generator sets, chillers, and the electrical contractors and controls engineers who commission all of it. There is a finite supply of each and a growing number of very well funded buyers. That is why transformer lead times have been measured in years rather than months, and it is not a situation that resolves because your project is smaller.

The practical version of this for anyone planning a cage expansion, a colocation move or an on premises build over the next couple of years: get power and equipment quotes far earlier than instinct suggests, and treat the power delivery date as your critical path rather than a formality that resolves itself. The rest of the project can absorb a slipped week. A substation cannot.

For the compute side of Anthropic's capacity picture, we covered its 10 billion dollar Norway compute deal and the reported lease talks with Meta earlier this year.
