  1. Start with a number you can trace
  2. Three financial views, three operational questions
  3. Build a forecast around dates and scope

The reported $3 trillion of technology-sector commitments concerns future spending. It should not be treated as three trillion dollars already spent, concealed conventional debt or a delivery schedule for usable AI capacity.

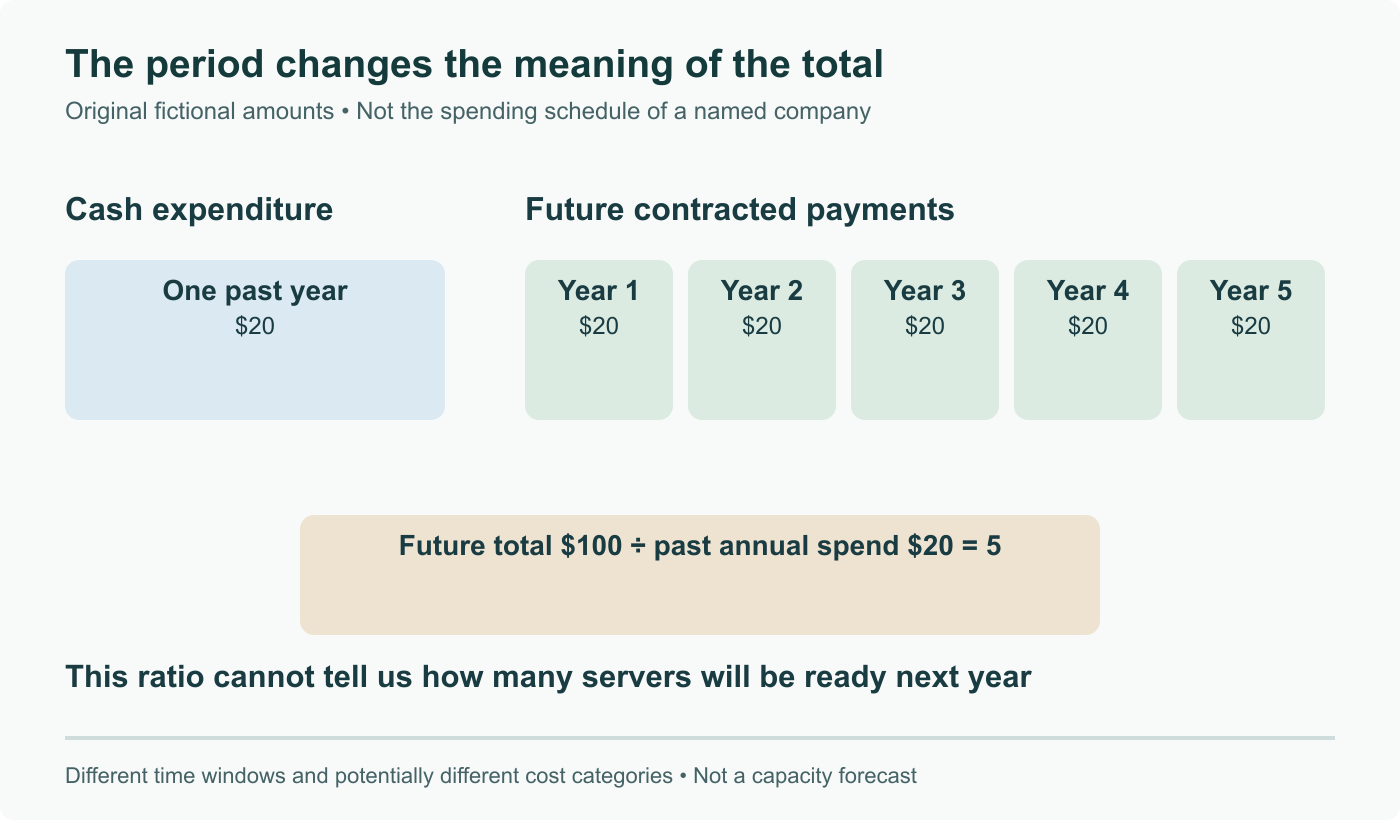

Original fictional comparison: $20 spent in one past year versus $100 of future obligations spread as $20 per year over five years. The 5:1 ratio compares different periods and does not measure a future server count.
Original fictional comparison: $20 spent in one past year versus $100 of future obligations spread as $20 per year over five years. The 5:1 ratio compares different periods and does not measure a future server count. Chart : PeopleAreGeek. Data source.
View full-size image

Start with a number you can trace

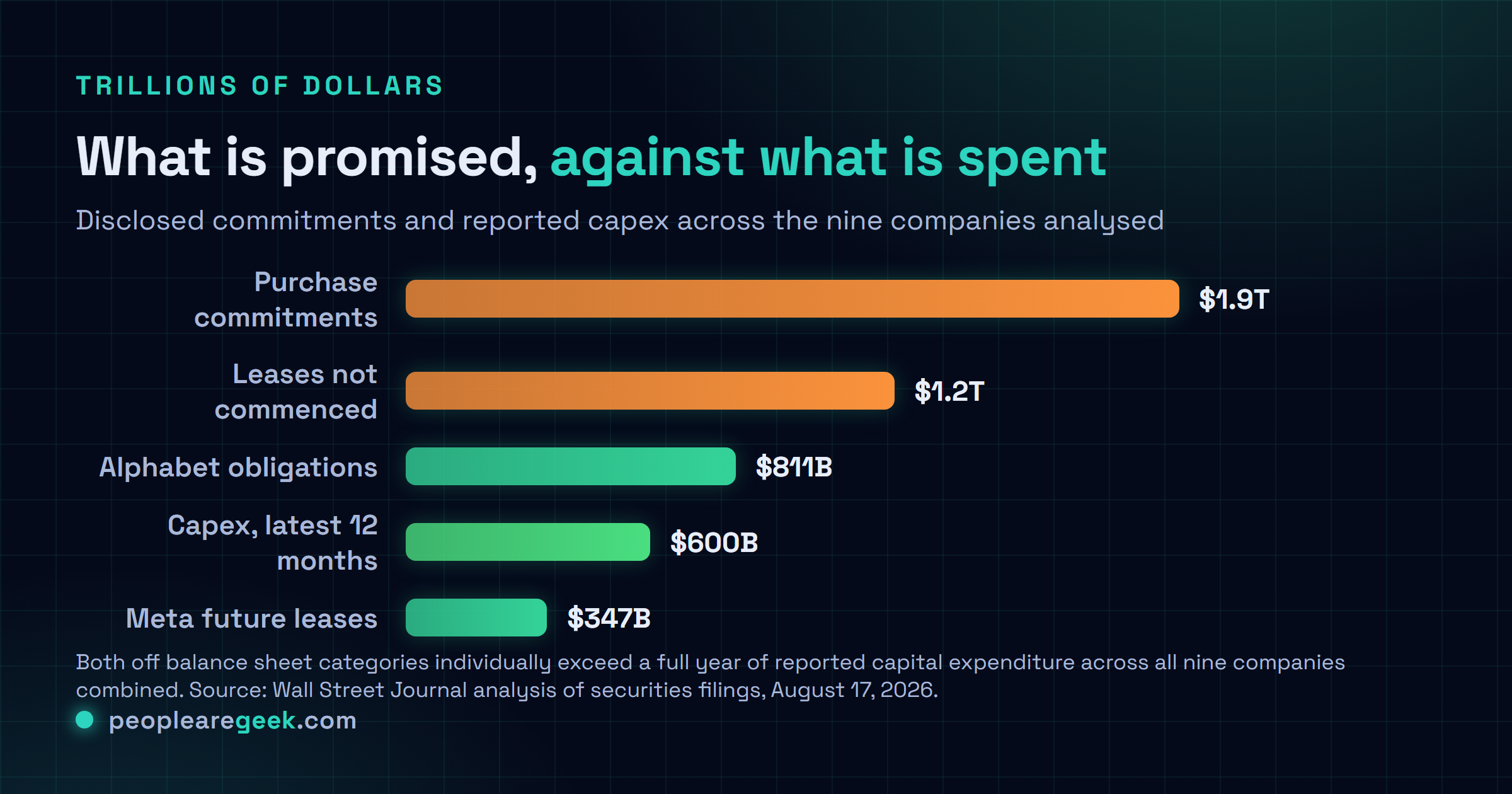

The Wall Street Journal article syndicated by Mint, published there on August 17, puts the headline at roughly $3 trillion. The accessible preview concerns future lease and purchase obligations. We have not independently reconstructed its complete nine-company aggregation, so the total remains attributed reporting.

A primary example is more useful than repeating the aggregate. Alphabet's June 30 quarterly filing discloses $811 billion in purchase commitments and other contractual obligations, with $200.7 billion short-term. The categories include technical infrastructure, inventory, content licences and energy contracts. Calling the entire amount “AI chips” would narrow the disclosed scope incorrectly.

Three financial views, three operational questions

Commitments describe contracted future obligations. Cash capital expenditure describes cash spent during a reporting period. Assets already purchased or under construction may still not be ready for service. None of these measures alone tells you the number of GPUs available to rent in a particular region.

The same Alphabet filing reports $122.8 billion of assets not yet in service and explains that installation and construction can take months or years. That is a direct reason to avoid equating money spent with capacity delivered. Likewise, a customer's cloud spending commitment is demand for service, not necessarily a matching new purchase of physical hardware.

The cover illustrates a fictional contract: $100 payable across five years versus $20 of expenditure during one year. Their 5:1 ratio is arithmetic, but it is not five times as many servers arriving next year. The figures cover different periods and may include different kinds of costs.

Build a forecast around dates and scope

For each obligation, record what is being supplied, payment timing, expected service commencement and any disclosed conditions. Keep lease payments distinct from equipment purchases and avoid adding two disclosures that describe the same arrangement. An undiscounted payment total is also not automatically comparable to a discounted liability balance.

Then connect the financial information to actual delivery evidence: an energized facility, installed systems, an accepted service date and capacity available under the relevant customer contract. The original article advised using a commitments-to-capex ratio to justify longer reservations. That conclusion was unsupported. The ratio can flag questions worth investigating; it cannot establish availability, pricing or the right commitment term for an individual buyer.

Keep reported aggregate attributed, verify Alphabet primary filing; distinguish commitments, capex, assets not in service and revenue backlog; remove direct capacity/contract advice.
